For the twin-tube tunnel segments, the construction team forms and concretes the bottom slab and walls in a single pour, then the slabs using two VARIOKIT Formwork Carriages. Among other things, the limited work space in the dry dock poses a number of challenges.
Marieholm Tunnel

Underwater tunnel connects the banks of the Göta älv river

One of the most interesting tunnels in Scandinavia, the Marieholm Tunnel, is currently being realized in the city of Gothenburg. In future, the 306 m long underground connection will ensure that the river Göta älv can be quickly crossed using the available six vehicle lanes. The structure is being constructed in the form of an immersed tunnel: three tunnel sections, each measuring more than 100 m long, are being produced in a dry dock with the help of a PERI VARIOKIT Tunnel Formwork Carriage and will subsequently be submerged in a trench excavated on the riverbed.

日付
02. 11月 2017
位置
Gothenburg, Sweden

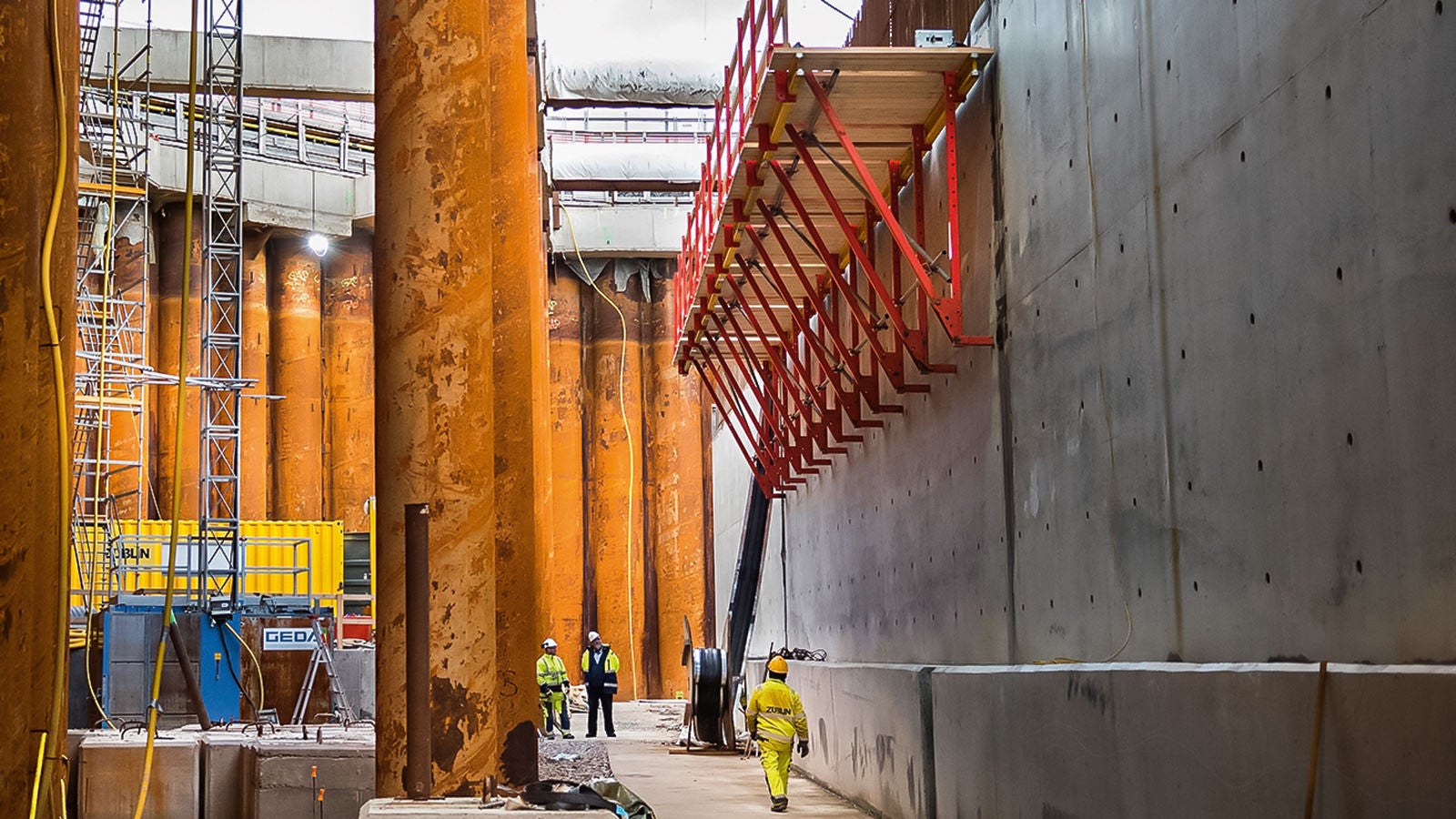

The formwork for the top external wall area, i.e. the counterpart to the internal arch, is supported by means of SCS Climbing Brackets. These brackets provide generous working areas and ensure safe load transfer into the previously concreted walls.

Download Press Release

The images in more detail

The following is an overview of the images contained in the press set.

The Göta älv connects Lake Vänern in the interior of the country with the open sea, with the 93 km long river being an important connection for inland transportation operations. Gothenburg is situated at the mouth of the Göta älv in the so-called Kattegat – the relatively shallow 80 m deep sea area between Jutland (Denmark) and the Swedish west coast. Due to the increase in traffic volume in the second largest city in Sweden, the new tunnel is currently being constructed and will later connect the city districts of Marieholm and Tingstad.

After completion, the Marieholm Tunnel will feature three carriageways in each direction along with a central service tunnel. Difficult ground conditions and the sensitive ecosystem of the Göta älv river have presented very challenging conditions during building operations. But the construction method has also brought its own challenges as the tunnel is being realized as an immersed tunnel.

6 years above water – 120 years underwater

The scheduled construction time for the tunnel is 6 years with the opening planned for 2020. For producing the three tunnel segments, each with a length of more than 100 m, an 18 m deep dry dock was created on the banks of the Göta älv as a direct extension of the finished tunnel itself. For this, a 120 m long and 40 m to 60 m wide working area was enclosed using steel sheet pilings and then pumped dry.

After production of the individual tunnel segments has been completed, the dry dock is flooded with water and the respective segment is pulled out on the surface of the river and then lowered to its designated position on the riverbed. The individual segments are subsequently joined together and the joints tightly sealed. After being used to manufacture the three tunnel segments, the dry dock area will be converted to form the transition section from the tunnel opening to the access road using the cut-and-cover construction method.

Due to the length of the tunnel segments reaching more than 100 m, the lowering procedure is a major task for the construction team. The tunnel has been designed for a service life of 120 years.

Individual exterior – standard interior

For forming and concreting of the individual segments as well as the tunnel exits, PERI developed a comprehensive formwork solution in close collaboration with Züblin Scandinavia AB. In addition to ensuring the simplest possible formworking operations, the focus was on maximizing the proportion of system components.

The cross-section of the three tunnel segments measures around 10 m in height along with a total width of more than 30 m with a middle wall separating each segment into two individual tubes. In a first step, the construction team formed and concreted the bottom slab and external walls of the twin-tube tunnel segments in one pour with casting segments of about 20 m. For the lateral stopends of the 1.50 m thick bottom slab as well as the 1.30 m thick external walls with heights of almost 6 m, PERI developed a project-specific solution based on the VARIO GT 24 Girder Wall Formwork. The internal wall was formed using the TRIO Panel Formwork system.

For the subsequent forming of the arches and slabs, PERI designed and delivered two tunnel formwork carriages based on the VARIOKIT Engineering Construction Kit each complete with a hydraulic lifting/lowering unit. Heavy-duty wheels and corresponding crane rails were used to move the almost 25 m long carriages. For the rounded arches in the upper area of the tunnel, the PERI team installed special elements; SCS Climbing Brackets support the wall formwork on the outer side of this top tunnel section.

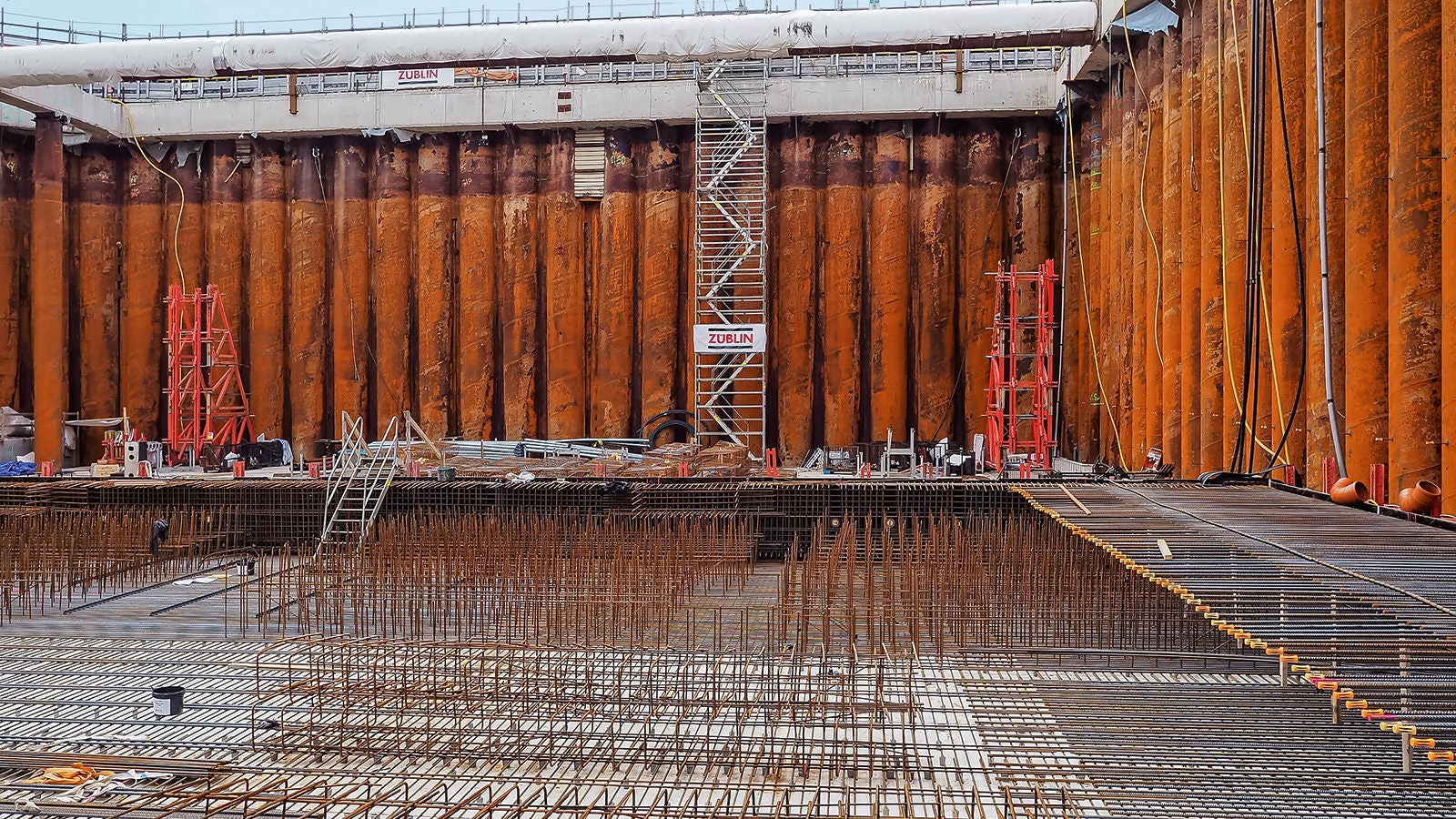

PERI UP Stair Towers and reinforcement scaffolding guaranteed safe and easy access to the dry dock and various working areas. After completion of the three segments, adjacent tunnel sections were realized in deep excavation pits using the cut-and-cover construction method.

Optimized planning and supply of materials

This unusual tunnel project required intensive and close cooperation between all parties involved – from the initial planning idea through to the final return delivery. PERI engineers were involved very early in the planning so that the execution idea could be developed into a cost-effective overall concept in collaboration with Züblin Scandinavia AB. The solution created was an optimized mix consisting of standard systems and project-specific formwork ensured efficient on-site work operations. The advantage of the VARIOKIT solution was its high degree of flexibility combined with a low weight which meant that the slab formwork carriage was relatively light weighing around 75 t. In addition, the carriage could easily be divided in a longitudinal direction thanks to its modular design: for the final removal of the formwork, the carriage was decoupled thus creating a total of six formwork carriage units which could then be easily removed from the dry dock in spite of the very limited work space.

Lastly, the option of renting materials was a very important decision-making criterion for the implementation of the PERI solution. On the one hand, this made it possible to fulfil all specific material requirements for the project; on the other hand, the optimum supply of materials to the construction site could be guaranteed. Both aspects provided additional cost optimization.
